Knowby
EWP Boom Insulation Testing
Standard Work Practice instructions on how to complete boom insulation testing
Standard Work Practice instructions on how to complete boom insulation testing
1
Step 1 of 24
<h3><strong>Purpose of EWP Insulation Resistance (IR) Testing</strong></h3><p></p><p>IR Testing confirms the <strong>surface condition and insulation integrity</strong> of insulated boom inserts between scheduled electrical tests required by <strong>AS/NZS 1418.10</strong>.</p><p></p><p>Because insulation can be affected by rain, moisture, fog, or contamination, this practice includes:</p><ul><li><p><strong>Visual inspection</strong></p></li><li><p><strong>Cleaning and polishing booms</strong></p></li><li><p><strong>Insulation resistance measurement</strong> of each boom section&nbsp;</p></li></ul><p>Operators <strong>shall</strong>&nbsp;complete IR testing on <strong>Work Group Meeting</strong> days or whenever an EWP returns from a major service.&nbsp;</p><p></p><p>This confirms the EWP chassis and boom inserts remain safe and effective.</p><p></p><p><strong>Note:</strong> Testing is not required if a scheduled electrical test will occur within two weeks of the Work Group Meeting or major service.</p>

Purpose of EWP Insulation Resistance (IR) Testing

IR Testing confirms the surface condition and insulation integrity of insulated boom inserts between scheduled electrical tests required by AS/NZS 1418.10.

Because insulation can be affected by rain, moisture, fog, or contamination, this practice includes:

  • Visual inspection

  • Cleaning and polishing booms

  • Insulation resistance measurement of each boom section

Operators shall complete IR testing on Work Group Meeting days or whenever an EWP returns from a major service.

This confirms the EWP chassis and boom inserts remain safe and effective.

Note: Testing is not required if a scheduled electrical test will occur within two weeks of the Work Group Meeting or major service.

2
Step 2 of 24

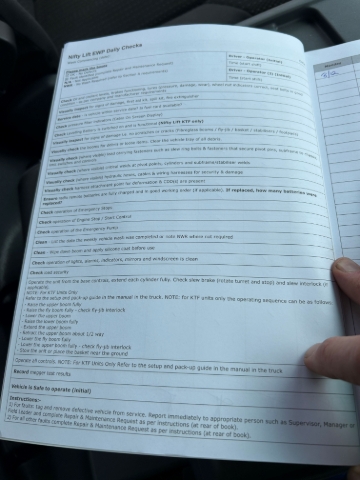

<p>Complete the EWP Daily Checklist </p>

Complete the EWP Daily Checklist

3
Step 3 of 24

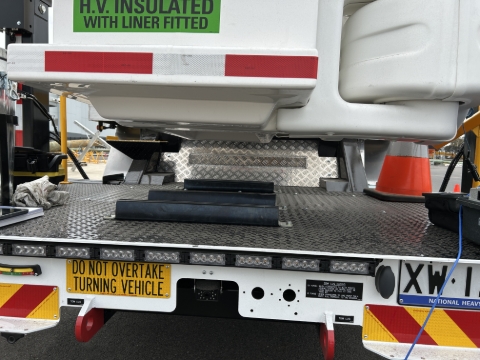

Prepare the EWP for test in a location away from traffic and pedestrians.

M

4
Step 4 of 24
<p>Wipe down any contaminants off the insulated sections of the EWP boom with Polywater Boom wipes</p><p></p>

Wipe down any contaminants off the insulated sections of the EWP boom with Polywater Boom wipes

5
Step 5 of 24
<p>Clean the sections of boom between the "Chassis Insulator" markings</p>

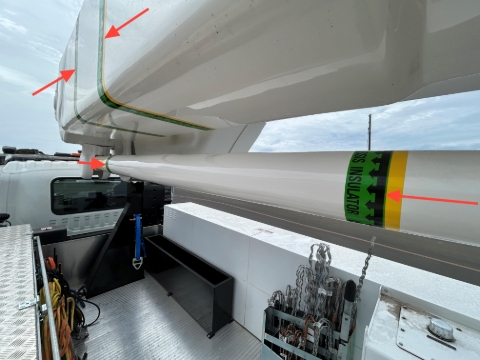

Clean the sections of boom between the "Chassis Insulator" markings

6
Step 6 of 24

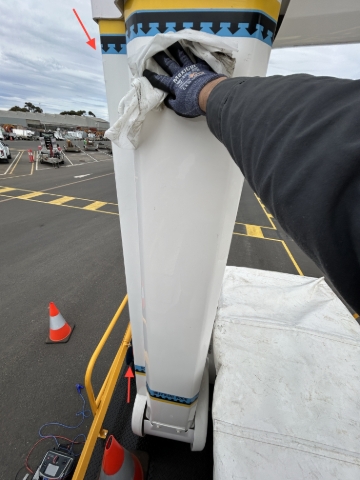

<p>Including the Fly Jib between the 'Boom Insulator' makings</p>

Including the Fly Jib between the 'Boom Insulator' makings

7
Step 7 of 24

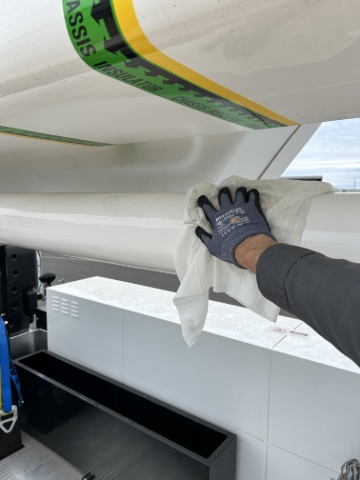

<p>Check and confirm all the dirt and grime has been removed</p>

Check and confirm all the dirt and grime has been removed

8
Step 8 of 24

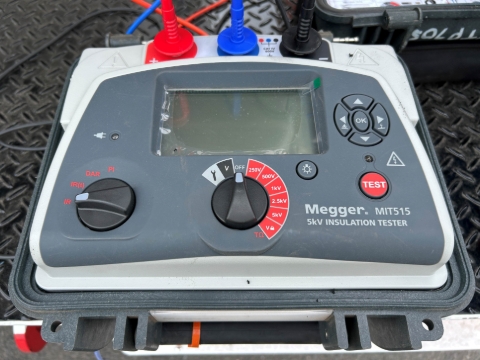

<p>Use a 5kV Insulation Resistance Tester with clamp leads. Test leads with banana plugs may be required for EWPs fitted with Megger Test Points.&nbsp;</p>

Use a 5kV Insulation Resistance Tester with clamp leads. Test leads with banana plugs may be required for EWPs fitted with Megger Test Points.

9
Step 9 of 24
<p>Before starting, confirm the calibration date information is correct</p>

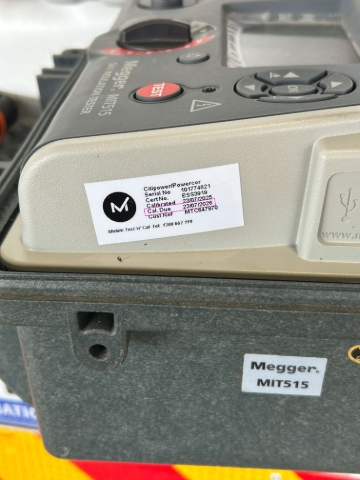

Before starting, confirm the calibration date information is correct

10
Step 10 of 24

Test the 'Open Circuit' functionality of the Insulation Resistance Tester

Plug the leads in, making sure they are not contacting any metal components or each other.

Select the 5kV function of the tester and press and hold the test button.

A correct 'Open Circuit' test result should be greater than 100GΩ

11
Step 11 of 24

Test the 'Closed Circuit' functionality of the Insulation Resistance Tester

Plug the leads in, making sure they are  connected.

Select the 5kV function of the tester and press and hold the test button.

A correct test result should be as close to zero as possible.

12
Step 12 of 24

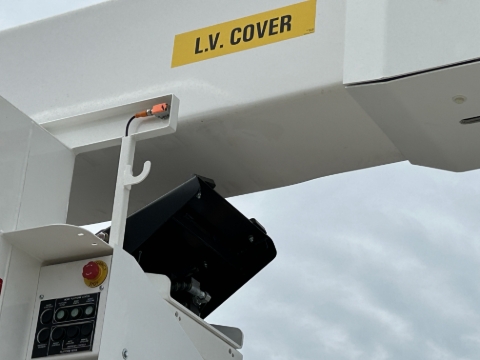

<p>Remove the EWP boom tie-down straps and elevate the upper and lower booms, making sure both booms and the basket are clear of their respective rests. </p><p></p>

Remove the EWP boom tie-down straps and elevate the upper and lower booms, making sure both booms and the basket are clear of their respective rests.

13
Step 13 of 24
<p>Make sure all the booms and basket are a minimum 100mm clear&nbsp;</p>

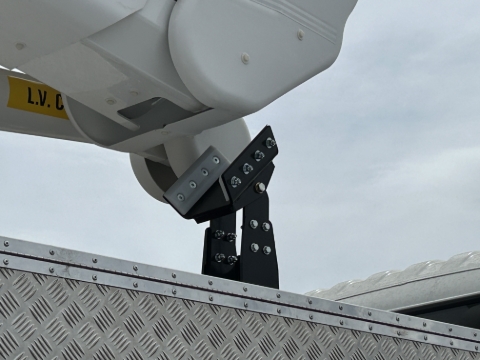

Make sure all the booms and basket are a minimum 100mm clear

14
Step 14 of 24
15
Step 15 of 24
<p>Before commencing IR testing, connect the insulation resistance tester to the Earth Stud of the EWP</p>

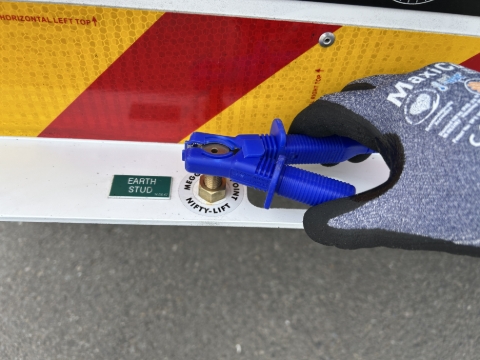

Before commencing IR testing, connect the insulation resistance tester to the Earth Stud of the EWP

16
Step 16 of 24

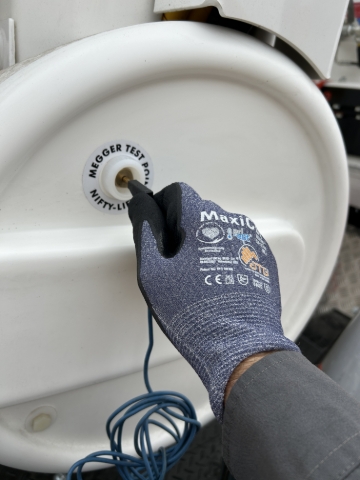

<p>Some Fly Jibs may have 'Megger Test Point' positions&nbsp;fitted either side of the 'Insulated Boom'.&nbsp;</p><p></p><p>Insert the test leads into both test points.</p>

Some Fly Jibs may have 'Megger Test Point' positions fitted either side of the 'Insulated Boom'.

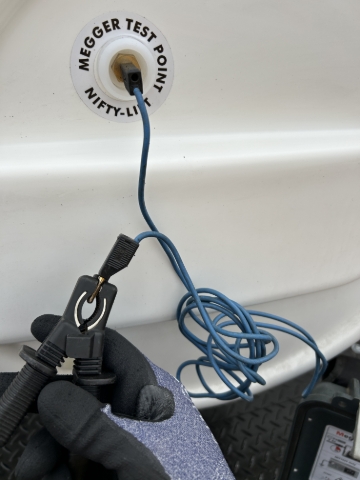

Insert the test leads into both test points.

17
Step 17 of 24
<p>Then connect the Insulation Resistance Tester clamps to the fitted leads</p>

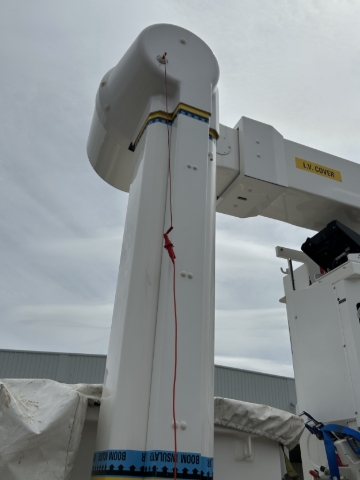

Then connect the Insulation Resistance Tester clamps to the fitted leads

18
Step 18 of 24
<p></p>

19
Step 19 of 24

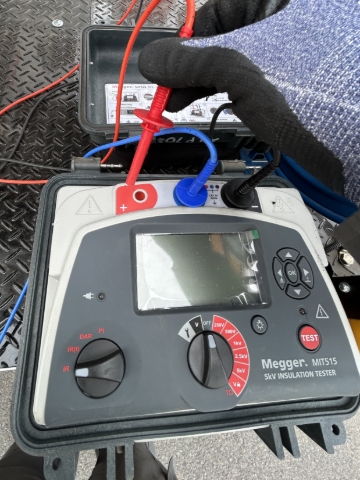

<p>Plug the test leads into the corresponding ports of the insulation resistance tester</p>

Plug the test leads into the corresponding ports of the insulation resistance tester

20
Step 20 of 24

Before Commencing any tests, check and confirm the following:

  1. Both Booms are lifted a minimum 100mm off their cradles.

  2. The EWP basket is elevated off the rest

  3. The Insulation Resistance Tester is bonded to the EWP via the 'Guard' port of the Insulation Resistance Tester

  4. The test clamps of the Insulation Resistance Tester are effectively connected via the test leads and test points.

21
Step 21 of 24

Select the 5 kV setting on the tester and press and hold the ‘Test’ button to start the test.

After about three (3) seconds—or three flashes of the red LED—press the ‘Test’ button again. The final test result will display.

Here the Fly Jib test result is 629 GΩ.

This is well above the ‘Good’ pass value of 100 GΩ, so no further action is required.

22
Step 22 of 24
<p>Where there is no 'Megger Test Points' fitted on the boom section, place the Insulation Resistance Test clamps on any available metal components either side of the 'Chassis Insulation' to be tested.&nbsp;</p><p></p><p>The example shown has the test clamps fitted to the lubrication grease nipples.&nbsp; &nbsp;</p>

Where there is no 'Megger Test Points' fitted on the boom section, place the Insulation Resistance Test clamps on any available metal components either side of the 'Chassis Insulation' to be tested.

The example shown has the test clamps fitted to the lubrication grease nipples.

23
Step 23 of 24

Follow the same testing procedure as shown earlier.

In this example, the bottom boom test shows a final reading of 22.8 GΩ, which is considered 'Fair' and passes.

Test Result ranges:

  • Good: Greater than 100 GΩ - Clear pass, no action required.

  • Fair: 100 GΩ to 2 GΩ – Pass, but requires additional cleaning and polishing.

  • Poor: 2 GΩ to 0.5 GΩ – Requires extensive cleaning and polishing, including internal high-pressure washing of the boom.

  • Failure: Readings below 0.5 GΩ. EWPs must be withdrawn from service. Investigate to confirm:

    • No conductive hydraulic hoses have been fitted

    • No hydraulic oil residue exists on or in the boom.

After inspection and eliminating these issues, complete a thorough cleaning and polishing before retesting.

Note: Allow the boom to dry completely before retesting.

24
Step 24 of 24
<p>Finish completing the EWP Daily Checklist and record each insulated boom section reading as shown.&nbsp;</p><p></p><p></p>

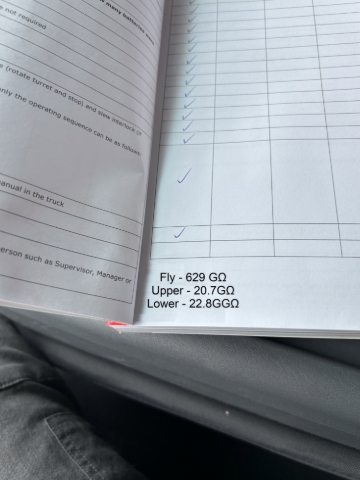

Finish completing the EWP Daily Checklist and record each insulated boom section reading as shown.
